Introduction
Kayne Avenue Missionary Baptist Church has served its Nashville congregation for generations, and like many long-standing places of worship, its building has to keep working every single week. So when a severe storm swept through the area and damaged the church’s roof and several large sanctuary windows, the congregation faced a familiar but difficult question: how do you take on a major construction project without ever closing the doors?

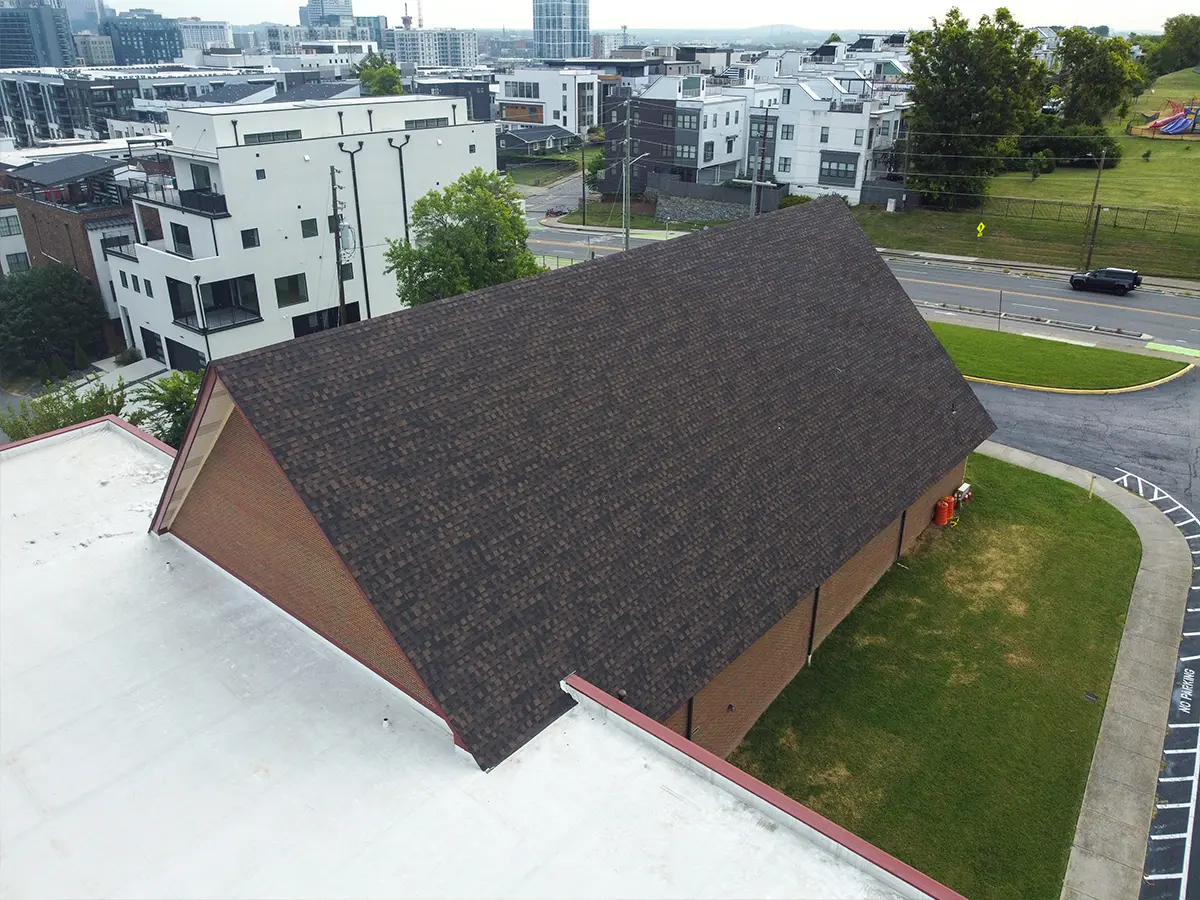

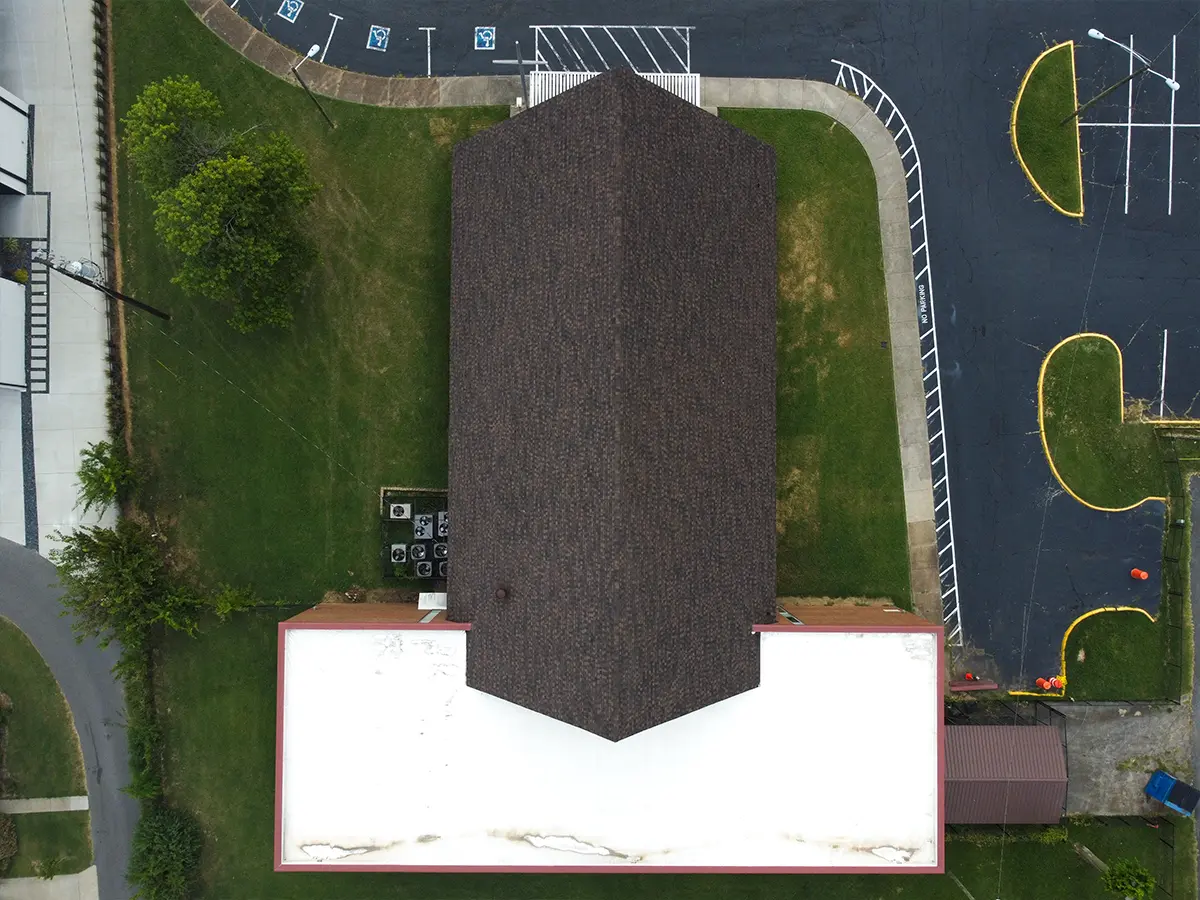

The damage required a full roof replacement, not a patch job. The church’s roof is a steep 12/12 pitch, roughly 9,400 square feet, which immediately narrows the field of contractors who can safely and correctly work on it. Mr. Roof Nashville was brought in to assess the damage, design a replacement plan, and execute the work while Sunday services, ministry programs, and everyday church operations continued uninterrupted.

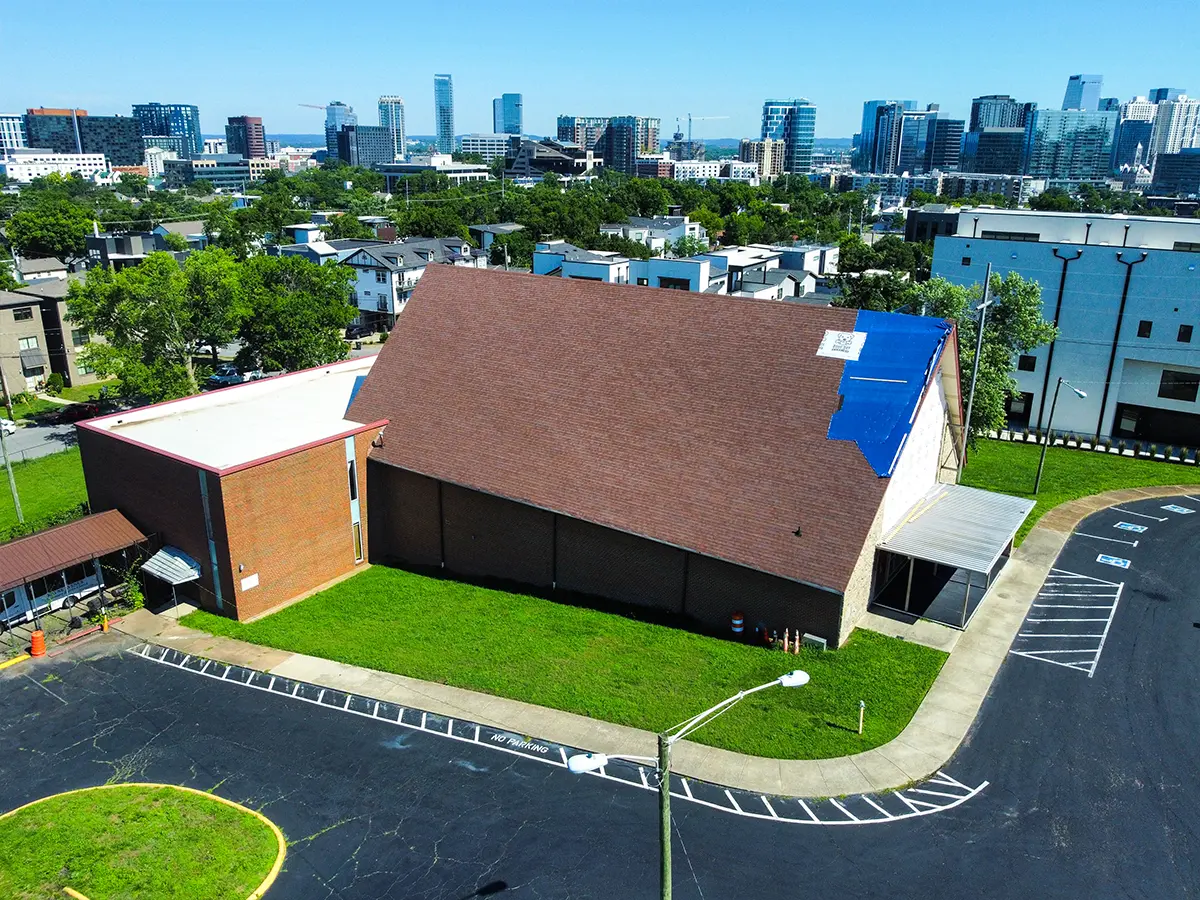

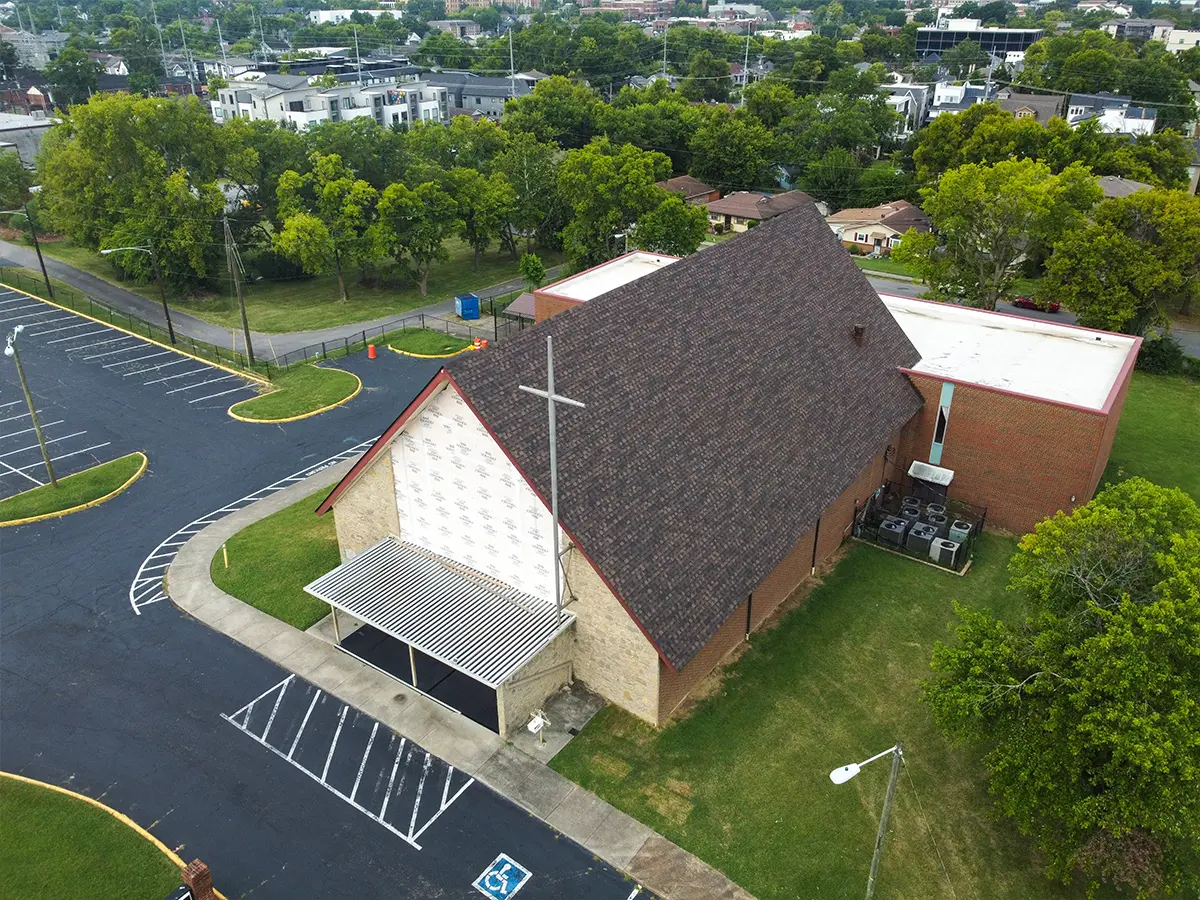

The project came with a second complication partway through: another round of storms rolled through while the roof was partially open. The team adapted in real time, protecting the exposed structure and picking the work back up as soon as conditions allowed. The result was a fully replaced, 30-year warrantied roofing system delivered in seven days total, with only three days of active labor required, and a congregation that never lost use of its building.
Project Snapshot
- Facility: Kayne Avenue Missionary Baptist Church
- Facility Type: Church / Place of Worship
- Location: Nashville, Tennessee
- Roof Size: 94 squares (approx. 9,400 SF)
- Roof Pitch: 12/12 (steep slope)
- Roofing System: IKO Dynasty Shingles
- Underlayment: Synthetic underlayment
- Scope of Work: Full tear-off and replacement
- Manufacturer Warranty: 30-year shingle warranty
- Workmanship Warranty: 5-year workmanship warranty
- Active Labor Time: 3 days
- Total Project Duration: 7 days (including weather delays)
- Project Consultant: Tyler Kane, Mr. Roof Nashville
The Challenge
Storm Damage to the Facility

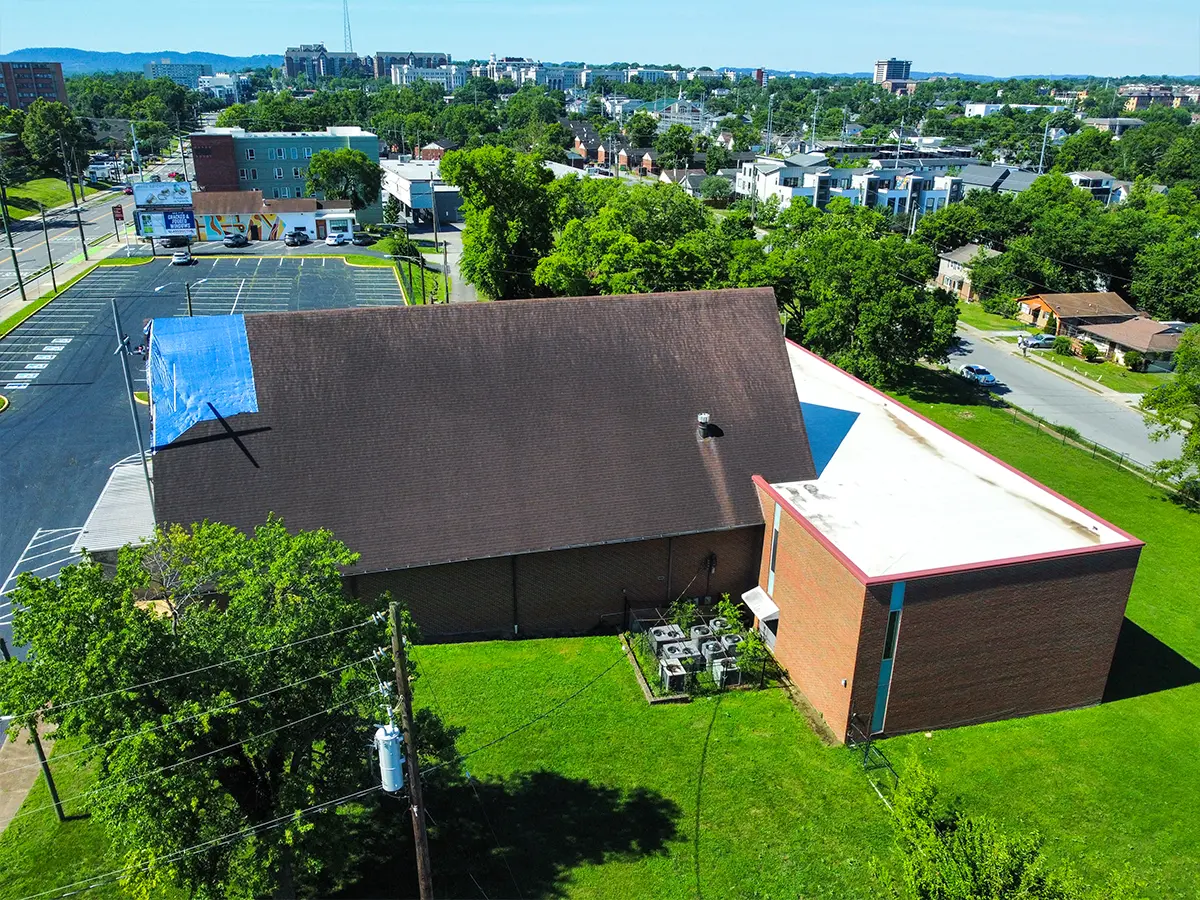

The storm left visible damage across the church’s roofing system and cracked or compromised several of the large windows fronting the sanctuary. Left unaddressed, that combination raised real concerns: continued exposure to wind-driven rain, the risk of water intrusion into the sanctuary and surrounding structure, and the slow, compounding damage that comes from a building envelope that’s no longer sealed the way it should be. The scope of the damage made clear that a repair would only buy time. A full replacement was the responsible path forward.
Steep-Slope Roofing Conditions

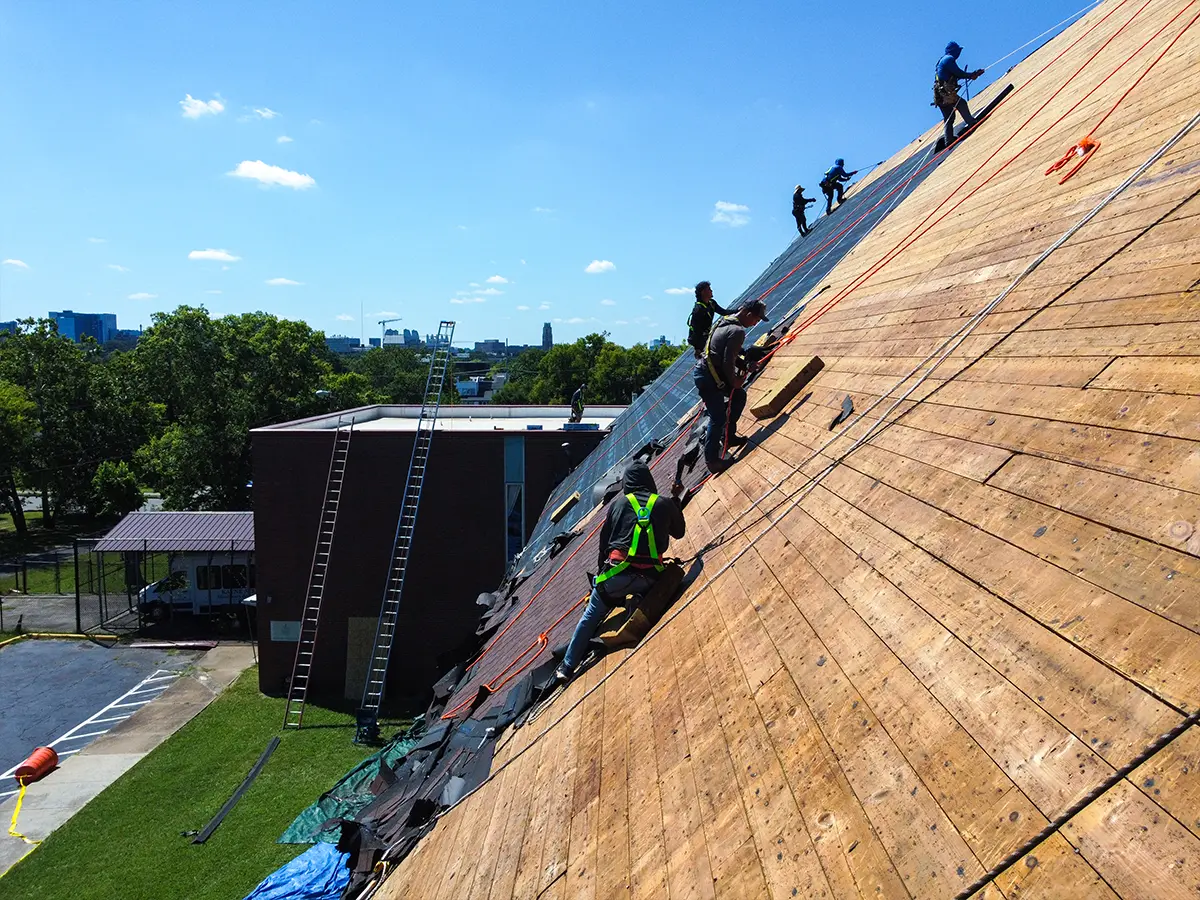

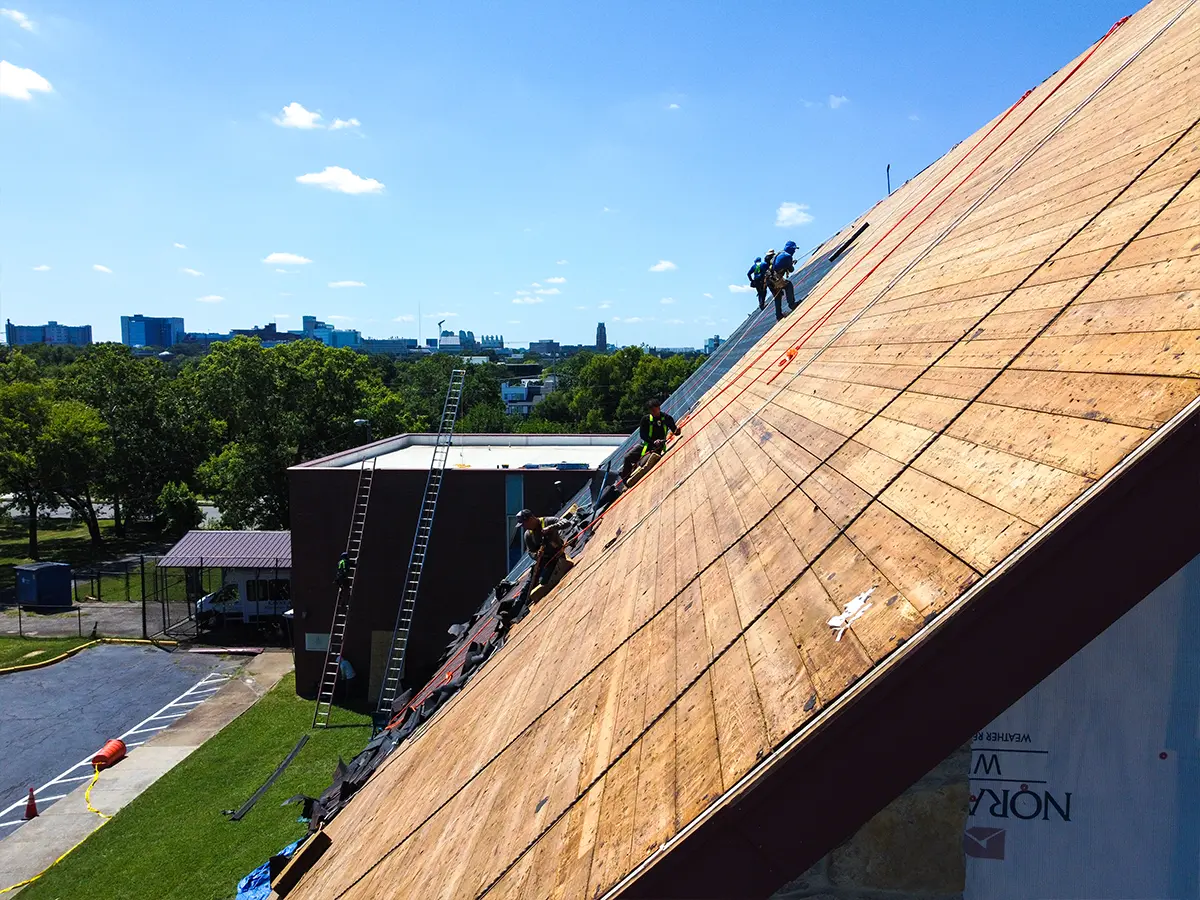

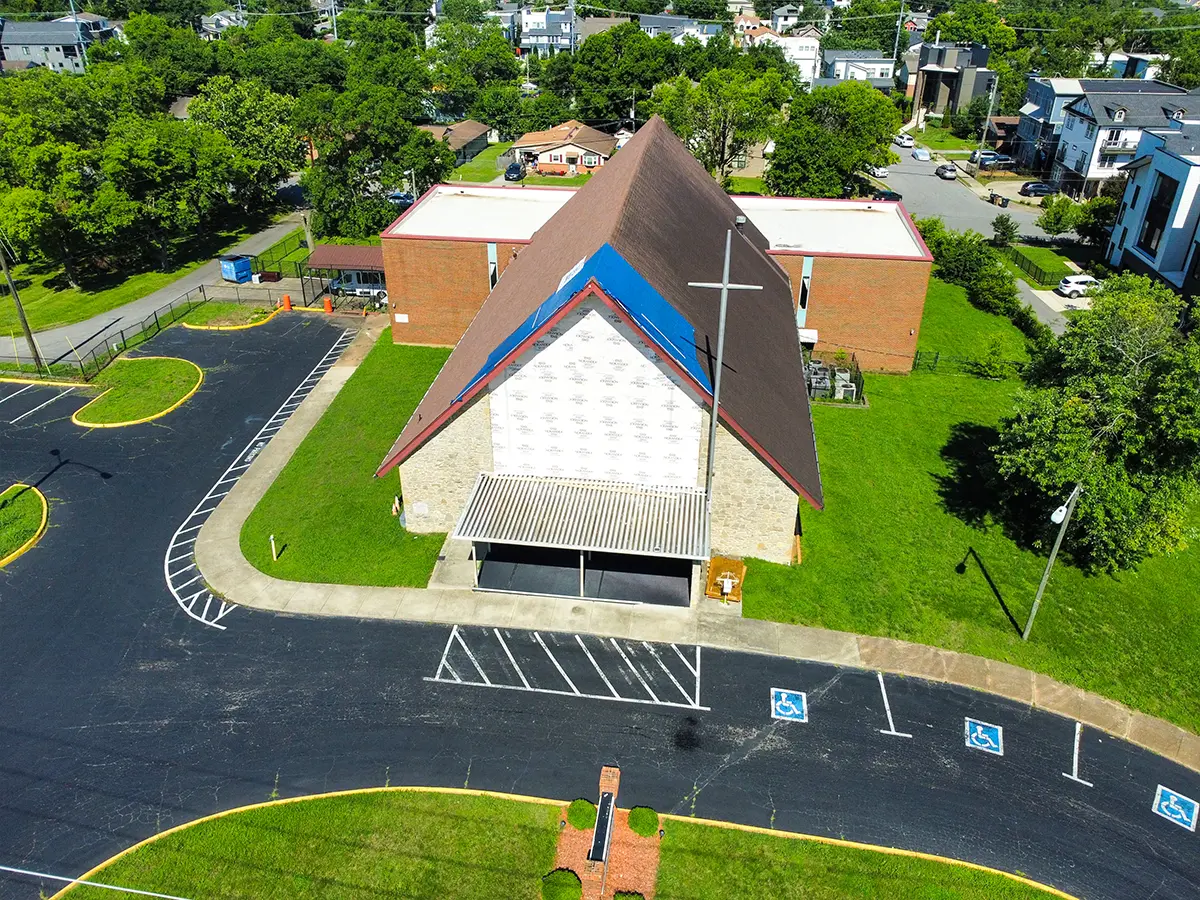

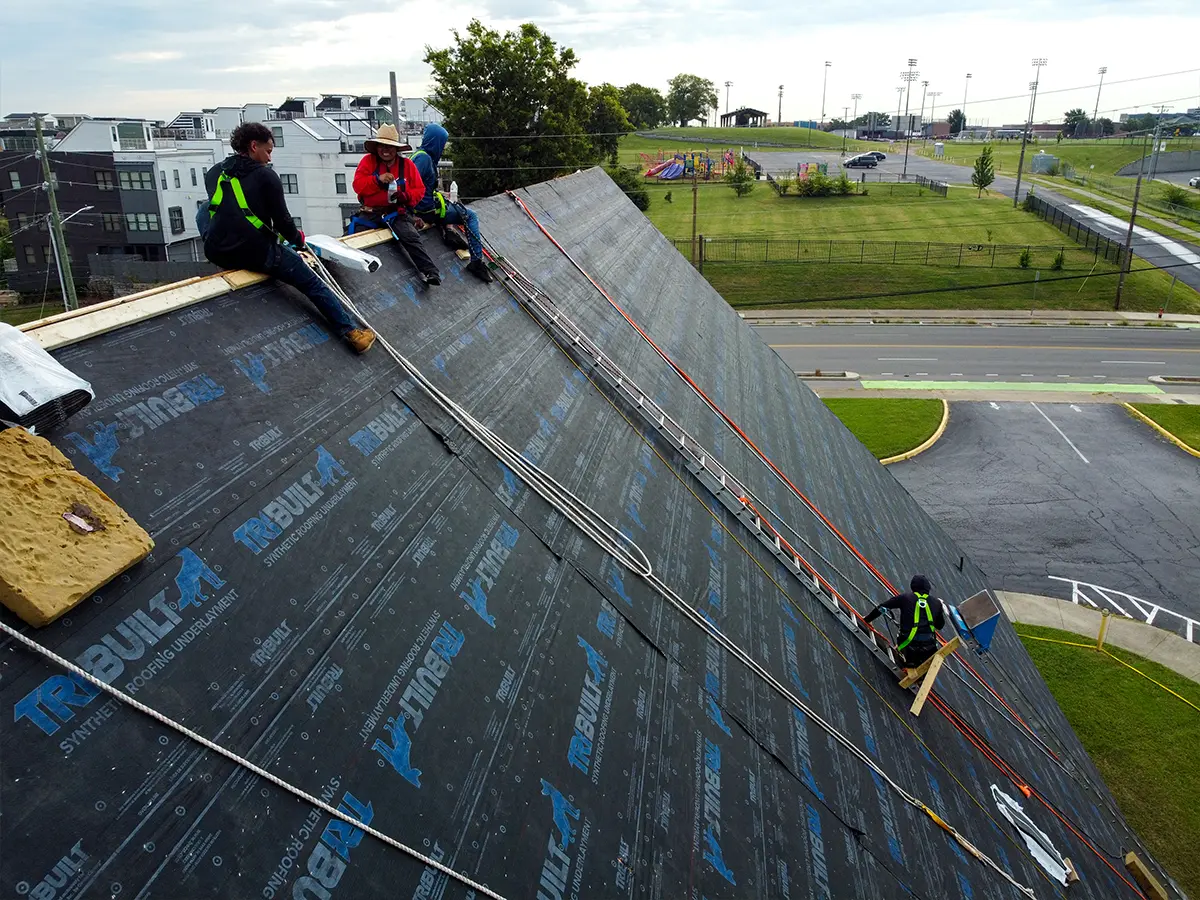

At a 12/12 pitch, this roof is about as steep as residential and light-commercial roofing gets, and it changes almost everything about how a crew approaches the job. Standard walking and staging techniques don’t apply. The project called for specialized fall-protection procedures, roofing crews experienced specifically in steep-slope work, deliberate material handling so shingles and underlayment could be moved and set safely, and tight coordination among crew members working at height for extended periods. It’s the kind of roof where experience is not optional.
Active Church Operations
Unlike a vacant commercial building, Kayne Avenue Missionary Baptist Church never stopped operating during the project. Worship services, congregation activities, and day-to-day facility use continued on their normal schedule. That meant the project team had to plan its work around service times, keep building access safe and predictable for staff and visitors, and stay in close coordination with church leadership throughout, so the roof came off and went back on without ever putting the congregation’s routine, or its safety, at risk.
Mid-Project Weather Interruptions

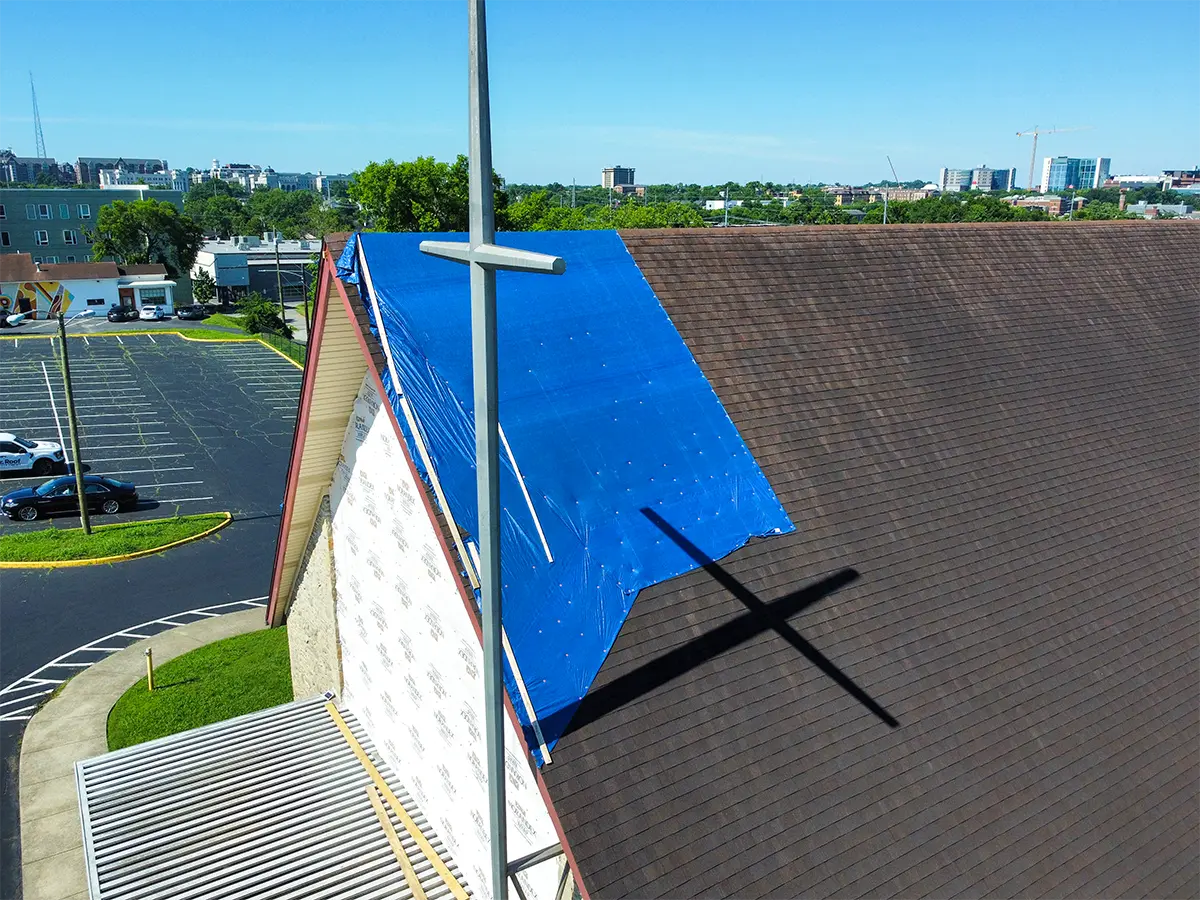

Partway through the tear-off, a second wave of storms moved into the area, an unwelcome complication with sections of the roof deck exposed. The crew shifted to protection mode: installing temporary ridge protection to shield the open structure, closely monitoring the weather to time their return safely, and pausing work until conditions allowed the team to get back on the roof without risking the building or the crew. That flexibility is what kept a weather delay from turning into a bigger problem.
The Solution
Mr. Roof Nashville approached the project in stages, starting with a comprehensive storm damage assessment to understand the full scope of what needed to be done. From there, the team built a replacement plan designed around two constraints that don’t usually appear together: a steep, technically demanding roof, and a facility that couldn’t close for the duration of the work.

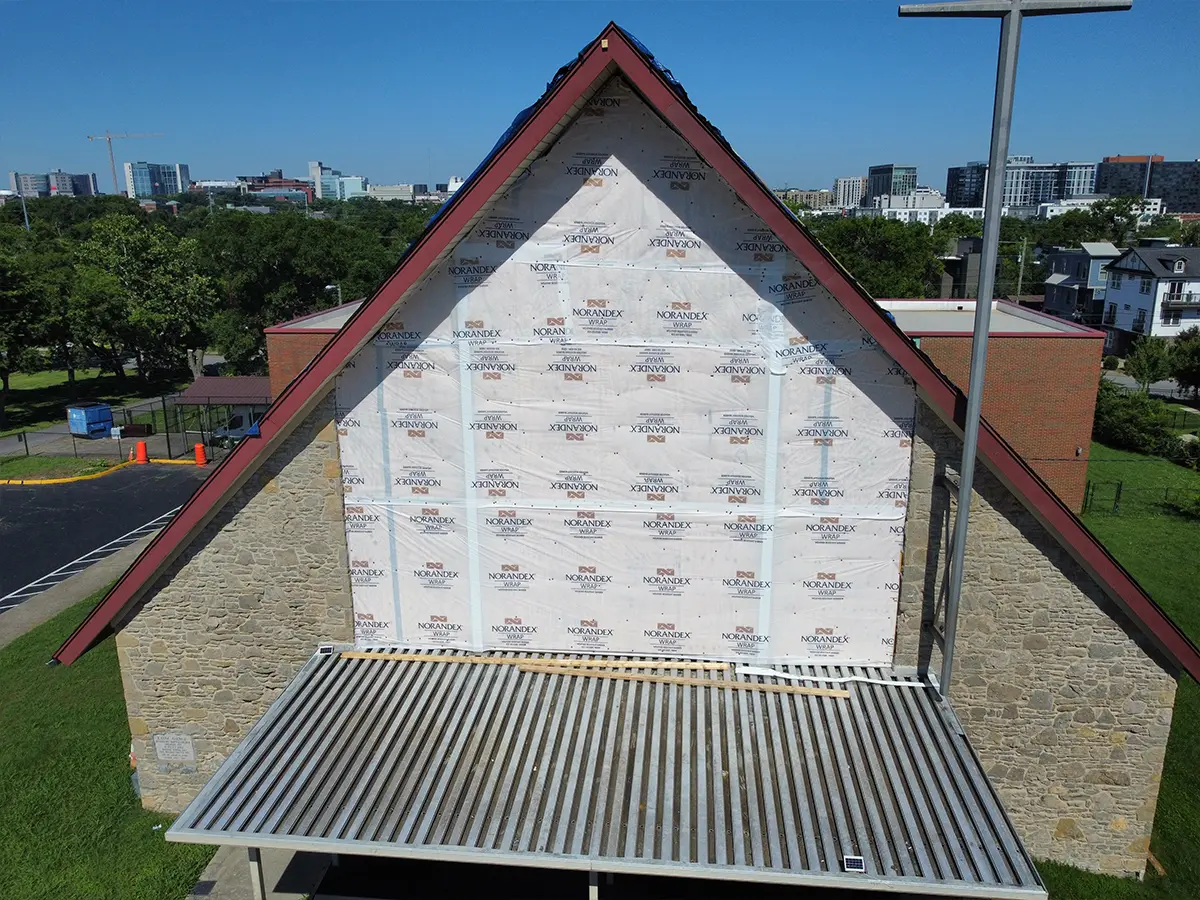

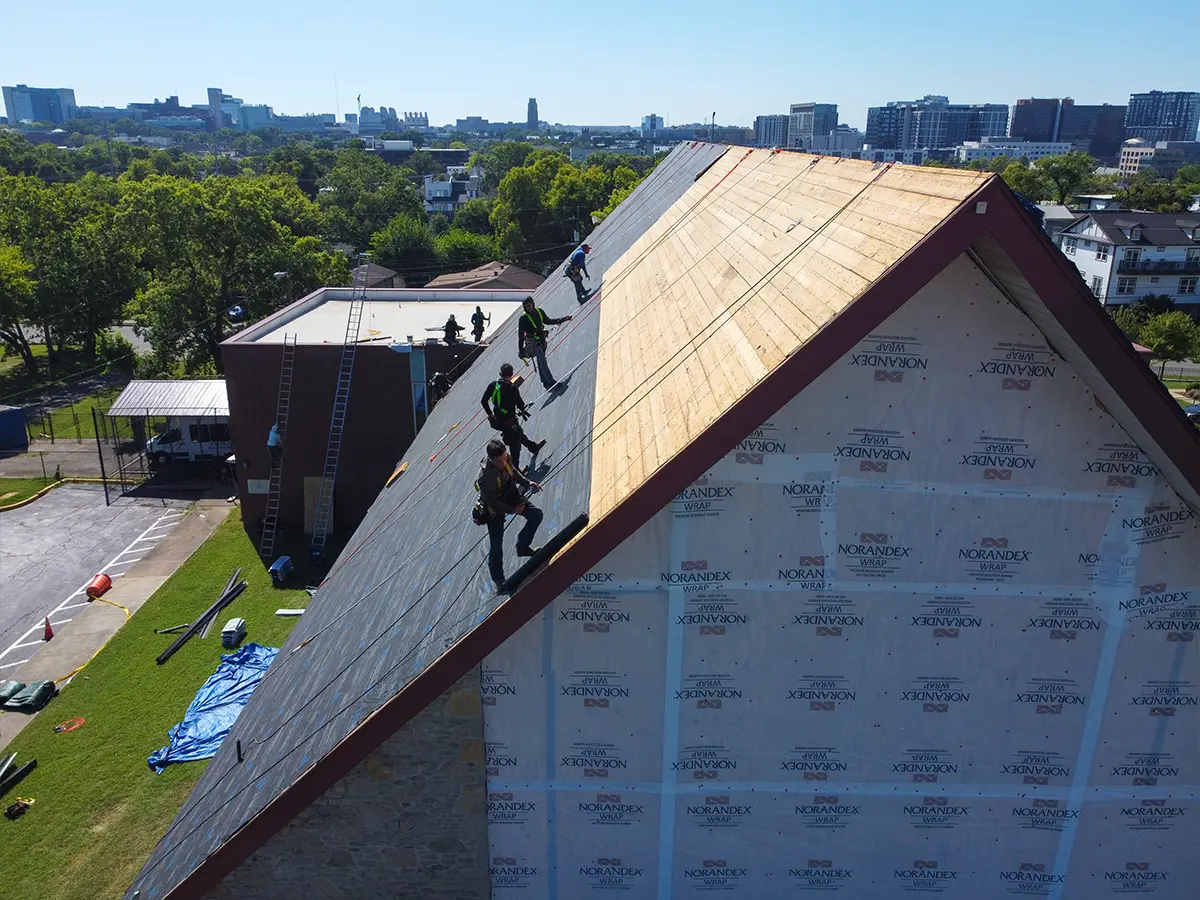

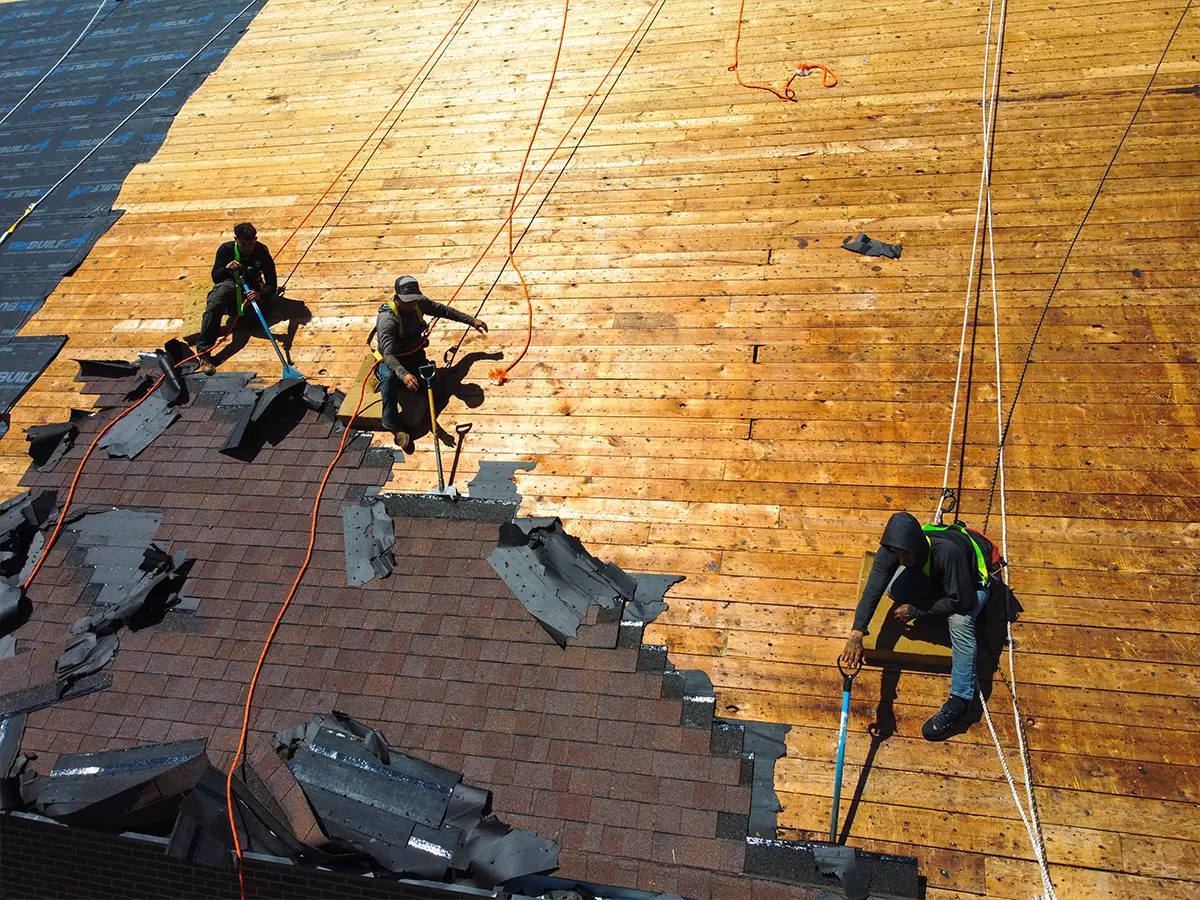

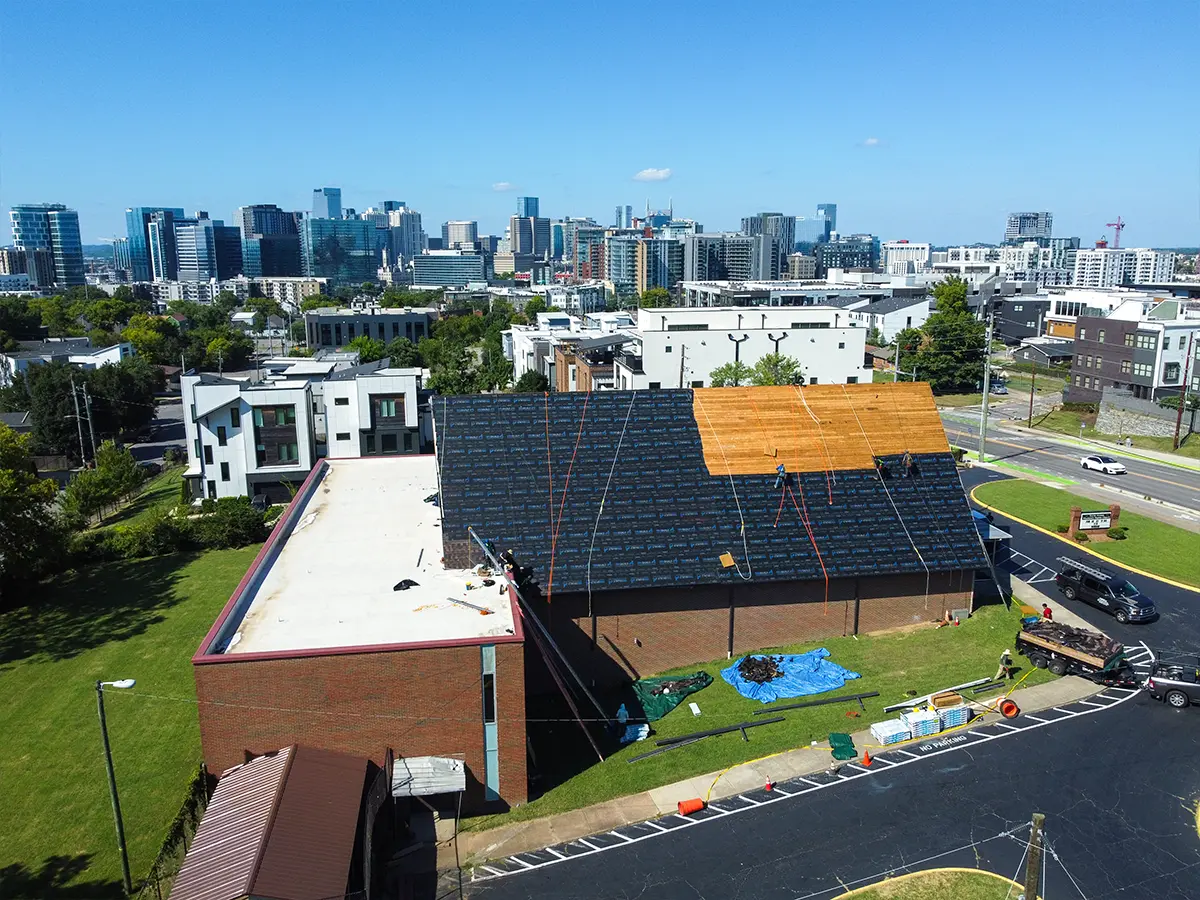

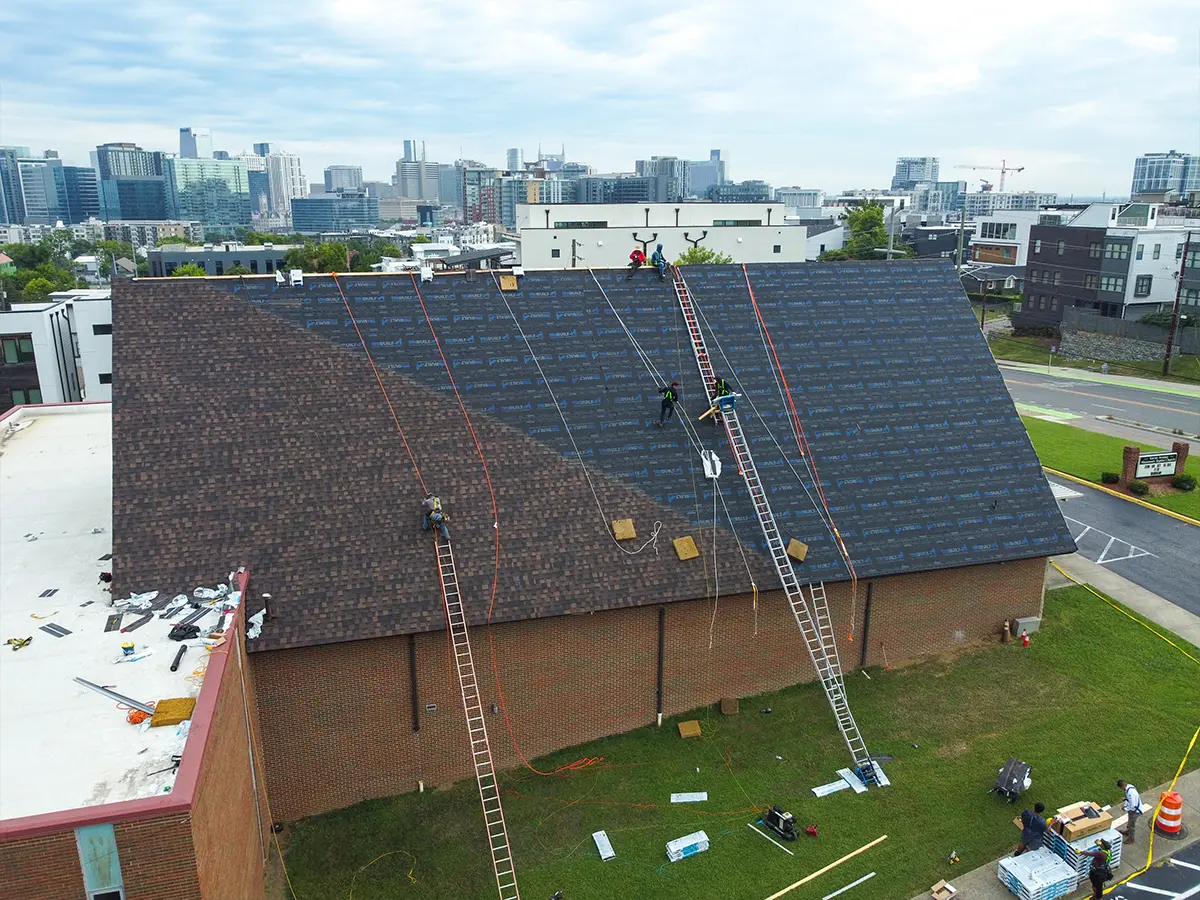

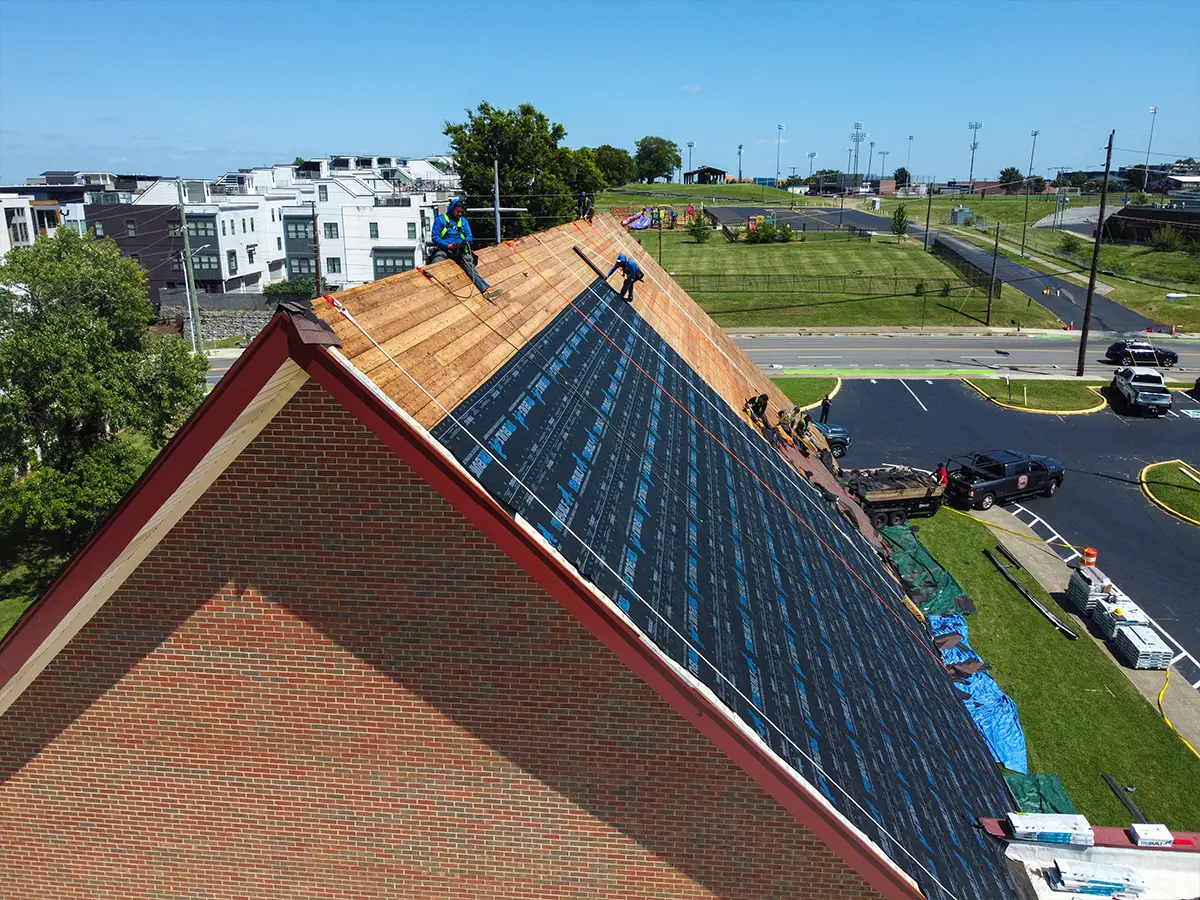

Execution followed a clear sequence. The crew performed a full tear-off of the existing roofing system, then inspected and prepared the roof deck to make sure the new system would have a sound surface to go over. Synthetic underlayment went down first, followed by the IKO Dynasty shingles, installed using steep-slope-specific procedures and safety protocols suited to the 12/12 pitch. Scheduling was built around the church’s calendar rather than the other way around, and when the mid-project storms hit, the team used temporary ridge-cap protection to keep the exposed structure secure until it was safe to resume.
Throughout the project, the team kept an open line of communication with church leadership, so there were no surprises about timing, access, or progress. That coordination, paired with a crew experienced in both steep-slope installation and occupied-facility work, is what allowed the project to move from storm damage to a fully replaced, warrantied roof in a single week.
“This was one of the more technically demanding roofs we’ve taken on this year,” said Project Consultant Tyler Kane of Mr. Roof Nashville. “A 12/12 pitch doesn’t leave much room for error, and neither does a church that can’t close its doors. Our crew planned around every service and adjusted through two rounds of storms, and I’m proud of how they protected that building every step of the way.”
Results & Client Impact
The finished project delivered exactly what the church needed: a durable, code-compliant roofing system installed with minimal disruption to church life. Key outcomes included:
- Full replacement of approximately 9,400 SF (94 squares) of steep-slope roofing
- Just 3 active labor days, with 7 total days including weather delays
- The building stayed protected throughout every weather interruption
- Worship services and congregation schedules were accommodated without closures
- Meaningfully improved weather resistance and building envelope performance
- Improved curb appeal for a highly visible community facility
- Long-term protection backed by a 30-year manufacturer shingle warranty
- Added assurance from a 5-year workmanship warranty
- Greater peace of mind for church leadership heading into future storm seasons
Why Church Roofing Projects Require Specialized Experience
Churches and other institutional facilities aren’t just larger houses. They operate on their own rhythm, answer to their own leadership structures, and carry long-term stewardship responsibilities that most residential projects never touch. The Kayne Baptist Church project illustrates what that means in practice.
Coordinating Around Worship Schedules
Construction on a church has to work around more than a single weekend service. Ministry programs, midweek meetings, community events, and staff schedules all compete for the same building. A contractor experienced in institutional work plans the job around the facility’s calendar, not the other way around, so roofing work and church life can happen at the same time without conflict.
Maintaining Safe Access
An active church needs safe, predictable access every day work is underway, from entrances and parking areas to the pedestrian routes staff and visitors use to move through the property. Keeping those paths clear and secure, even while material staging, equipment, and crews are on site, takes deliberate planning that goes beyond typical residential jobsite management.
Managing Occupied Facilities
Working on a building that never closes changes the calculus for nearly every phase of a project, from staging and cleanup to noise, timing, and site containment. It requires a level of daily discipline that unoccupied commercial or new-construction projects simply don’t demand.
Working With Church Leadership and Facility Committees
Church projects typically involve more decision-makers than a single homeowner or property manager, including pastors, trustees, facility managers, building committees, and finance committees. Keeping a project on track means communicating clearly and consistently with all of them, not just the person who signs the contract.
Long-Term Stewardship and Budgeting
For most congregations, a new roof is a capital decision with a long horizon. It affects maintenance budgets, future repair risk, and how the building performs for decades to come. Experienced contractors help church leadership think through those long-term stewardship questions, not just the immediate scope of work, and back the decision with real warranty protection.
Steep-Slope Architectural Roofing Expertise
Many churches, including Kayne Avenue Missionary Baptist Church, were built with steep, architecturally prominent rooflines that demand specialized safety practices, purpose-built equipment, hands-on installation experience, and tight crew coordination. It’s not a roof every contractor is equipped to take on, and it’s exactly where a specialized team makes the difference between a project that goes smoothly and one that doesn’t.
Need a Roof Assessment for Your Church?
Mr. Roof Nashville works with churches, schools, and institutional facilities across the Nashville area on professional roof inspections, storm damage assessments, storm restoration, and complete roof replacements. Whether your facility has visible storm damage or you’re planning for long-term roof stewardship, our team understands what it takes to get the work done right, on a schedule that respects how your facility operates.
Contact Mr. Roof Nashville to schedule a comprehensive roof evaluation for your church or institutional property.
